I’m a little late to this party but here’s my way of looking at this type of 10,000 foot stuff. (Plus, it also adds a bit of a look “up” into the higher elevations if you set up your projects with the right info.)
I too am an OmniFocus user, so my approach is 100% OmniFocus-based. I am assuming that you are running a solo or small shop operation. Gantt charts may look great but they are almost always wrong and introduce an overhead for micro-businesses like ours that offers no value.
The solution I believe, is a Perspective! Two Perspectives actually. They are very similar in construction, with subtle changes in the way they are sorted.
I call the first Perspective the “Quarterly and Annual Planning Review”. This Perspective groups all of my current and upcoming projects with Due Dates by Project, then by Due Date. The second Perspective is very similar and is called “Significant Milestones”. The grouping by Project gets dropped and only tasks with Due Dates appear in the Perspective.
All of the sample data is tagged “sample” so that I could put some fake, but relevant tasks together to provide an example of how I look at these two Perspectives to make a decision. So if you make these Perspectives, you do not need the “Tagged with Sample” condition. Each of the tasks are broad — they are at the 10,000 foot level on purpose. You may actually want to tag 10,000 foot tasks as such for inclusion in these or any other type of Perspective you come up with.
Let’s say I’m currently working on “Project 1” and “Second Big Project”. Later in the year I know I will have “Something to do in Quarter 2”, “Project for Mr. Burns” and “The Biggie Later Project”. Now, along comes a client request to get something done in the next couple of weeks (let’s say it came in on Feb. 23…). I think I can do it and I enter the project into OmniFocus as “Should I do this Project?”. There are 2 key tasks to do for the project and they will total about 150 hours. The project is due on Mar. 15.
With the proposed project and its framework (ie: 10,000 foot level) tasks entered, I can now take a look at my two key Perspectives to see how things will land. I should likely also have my calendar open too, in order to check on upcoming holidays and family commitments. (You actually could put that stuff in OmniFocus too I guess, but that’s not how I do it…)

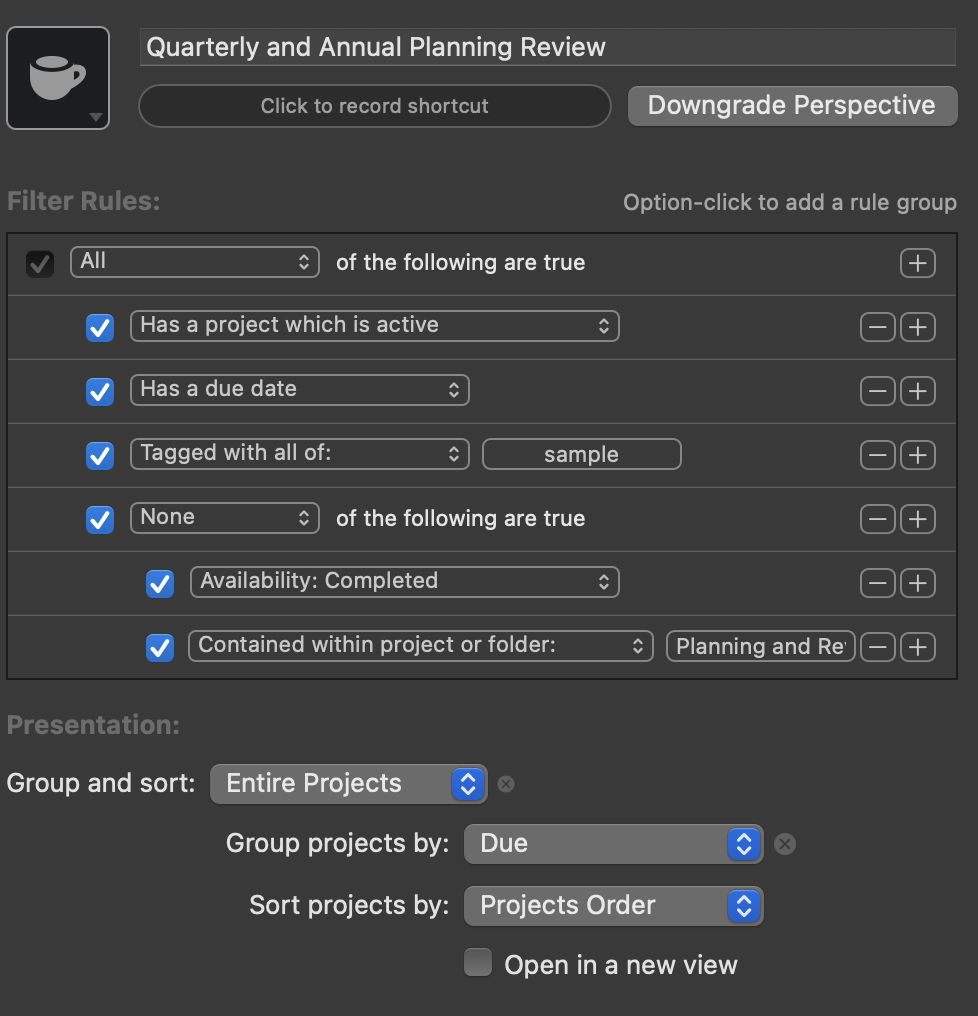

Let’s look at the “Quarterly and Annual Planning Review” Perspective first. What I like about this Perspective is that, because it is grouped by Project, the task that has to be done first pulls the whole Project ‘up’ toward the top of the Perspective. So, even though “Project 1” is not due until Apr. 2, it shows up as needing attention ‘In the next month’ because there are 2 tasks to be done by Mar. 21. In fact - wow! - there are 3 overlapping projects to work on over the next month. Now of course, one of those is the “Should I do this Project?”. Well, should you?

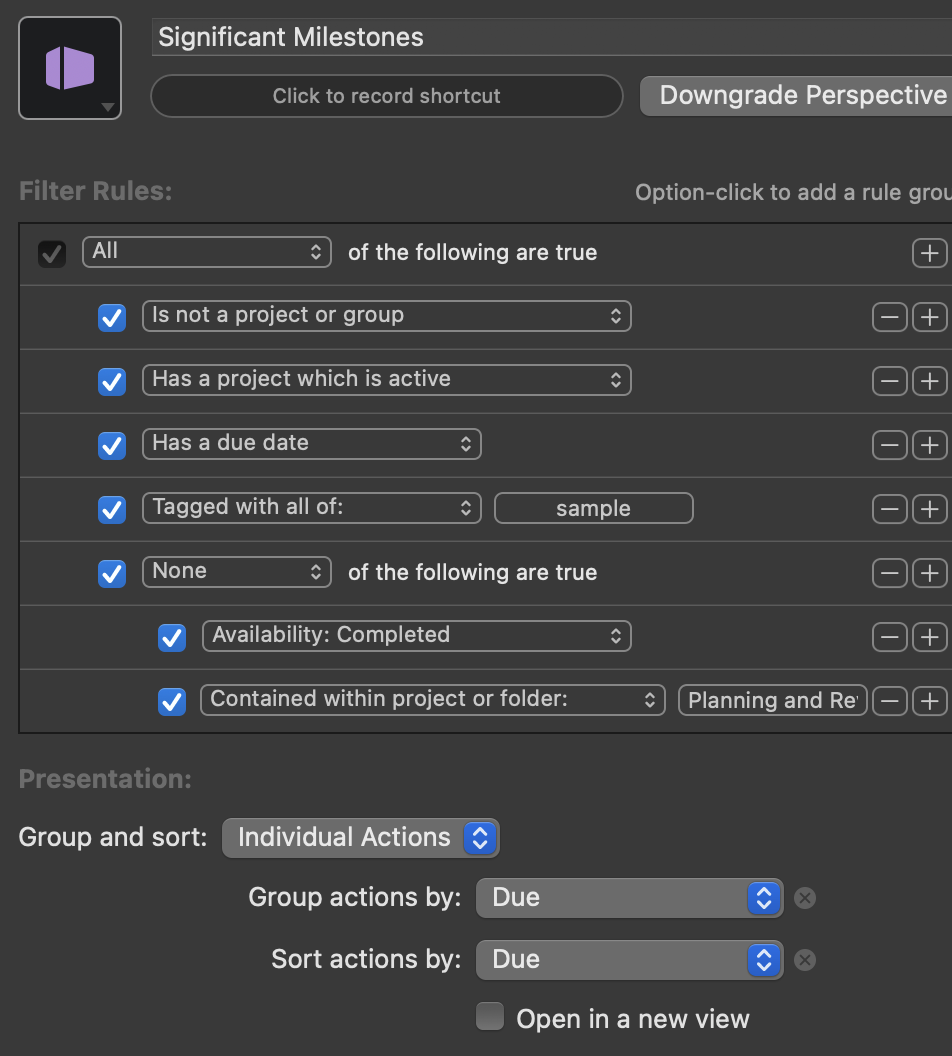

Let’s go to the “Significant Milestones” Perspective now. Take a look at the cleaner task listing in the Perspective. Now consider the underlying message in the data. It tells me that the answer is “No” to taking on the “Should I do this Project?” project. 150 hours of new work to be done by Mar. 9 (remember, it’s Feb.23 when we are looking at this data) when I already have 240 hours of committed work to do by Mar. 21 isn’t possible in my world. Of course it depends on what kind of work you are doing and if you have some other trusted people you could call in to help.
I use these two Perspectives a lot to assess what I will be doing in a “big picture” sense. They also help me in determining when I should say “Yes” or “No” in the months ahead.
